Showing posts with label data migration. Show all posts
Showing posts with label data migration. Show all posts

07 March 2024

Data Migrations (DM): The SQL Server Perspective (Licensing Costs and Edition Choices)

Data Migration
Data Migration Series

A Data Migration (DM) moves all or a subset of the data available from one or more system(s) into other system(s). For this purpose, especially in ERP Implementations, one can use a SQL Server as intermediate layer, where SSIS can be used for the data extraction and exporting, SSRS for reporting the errors, while the database engine for the heavy processing. Master Data and Data Quality Services can be used as well in certain scenarios. Therefore, SQL Server allows by design to address the various challenges related to a DM. At high level the architecture can be depicted as follows:

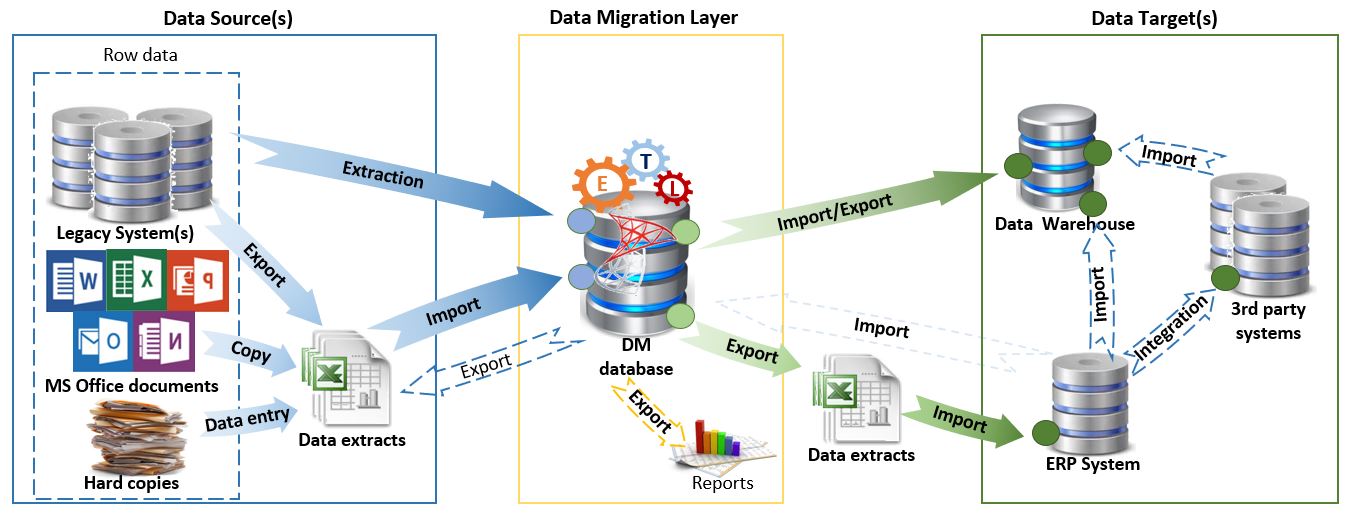

Data Migration Architecture
Data Migration Architecture

Once the decision to go with SQL Server for the DM layer is made, one needs to define which edition to use. If the DM doesn't have special requirements, one can use for it an available SQL Server instance, as long as the cumulated workloads don't create major issues. Therefore, in the past I used existing licensed versions of SQL Server to build solutions for DMs in ERP implementations, though I evaluated in each project whether it's possible to reduce the costs and remain compliant with the license requirements.

Of course, there's always the alternative of using SQL Server Express which supports databases with a maximum of 10 GB, which should be enough for most of DMs, though it has also further limitations (see [2]). There are also ways of moving around existing limitations, like splitting the logic across multiple databases.

Then there's the SQL Server Developer edition, which involves no license costs, has the full SQL Server functionality available, and can be used to build and test applications. In a recent post [1], Bob Ward, principal architect at Microsoft made several clarifications on the licenses for the Developer edition, which is "licensed for development, test, and demonstration purposes only" and "may not be used in a production environment”. Bob Ward makes the following clarifications:
(1) "Production environments include any system that is accessed by end-users for anything more than acceptance testing, environments that connects to production systems (such as Linked servers), disaster recovery or backups of production systems, and environments that are 'rotated' into production at any point in time." [1]
(2) One "cannot use Developer edition to build test data and move that same data into production" [1].
(3) One can "restore a production set of data backup for testing purposes" [1].

There are two-three impediments for using the Developer edition completely for a DM. The first, at least during Go Live and UAT, one needs to work with data coming directly from the various production environments. Secondly, the data generated by the solution are used primarily for UAT and in a second step for Production, which seems to be against the rule (2), or at least it's a grey area (which might be overlooked by Microsoft). Thirdly, some data from the production environment might need to be imported back into the DM layer for validation or enhancing the entities with data generated in the target systems.

In what concerns the first issue, the DM solution can always point to the test environments used as source, following that during UAT to copy the databases from production into the test environments. This might be anyway necessary for other purposes. Otherwise, the effort might be considerable and not working in the last phases with the data timeliness might raise other concerns.

The second issue is a matter of interpretation. The UAT phase makes sure that the data generated by the DM solution respects the criteria for Go Live. If there are no issues, the same data can be used for Go-Live. If for this is required another licensed edition, then an environment can be built only for UAT and Go Live, project phases which usually span over a couple of weeks, unless multiple migrations need to be performed at different time intervals. If the environments are in the cloud, probably the instances can be turned on and off on a as-needed basis.

One can plan for different environments between Production and Development and the environments can be on the same SQL Server as distinct databases, respectively use the Developer edition for Development, and use a different licensed edition for UAT and Production. This approach involves additional overhead in synchronizing the logic between environments. Conversely, in the case of the DM layer, the same environment can be used from beginning to the end, while the code should/must be backed-up periodically. For multiple migrations based on the same data, one should archive the data after each migration or important phase.

For the scenarios in which after migration the data are copied back to the DM solution, it's enough to have these steps performed against the UAT target system(s). This should work as long there are no differences in configuration between UAT and Production. There are however exceptions, e.g. data generated by the target systems, for which the values between Prod and UAT are different. At least in Dynamics 365 one can attempt to generate the values in the DM layer and import them as they are into the target system. It worked for many scenarios, though there can be exceptions here as well.

A more complex scenario is when data from the DM layer needs to be exported to Data Warehouses or similar solutions that can be considered as Production systems. Here a licensed edition seems to be mandatory. For other scenarios in which Master Data and/or Data Quality Services are needed, there's only the option to use the Enterprise or Developer editions.

To summarize, to reduce the overall costs for the DM, consider using an existing licensed SQL Server instance for building the solution. If separates environments need to be built, the Express edition might have some limitations though it can prove to be a viable solutions in many cases. Otherwise, consider the above workarounds for using the Developer edition, including the scenario in which distinct environments are used for Production and Development.

Resources:
[1] Microsoft Data Platform (2024) How SQL developers can maximize savings, by Bob Ward (link)
[2] Microsoft Learn (2024) Editions and supported features of SQL Server 2022 (link)
[3] Microsoft Learn (2023) Master Data Services and Data Quality Services Features Support (link)

10 January 2024

Data Migrations (DM): Create a Data Migration Strategy for Dynamics 365

Data Migration
Data Migration Series

Microsoft made available a module on creating a Data Migration strategy (DMS) for Dynamics 365 solutions [1] and provides a template for the DMS workshop on GitHub. Despite the all-encompassing title, the module focuses mainly on the latter. Here are several points to consider in addition.

The workshop allows to gather most important aspects related to the DM, however it's useful to make the strategy explicit as part of a document and share it with the team. The DMS document should follow the general elaboration of a strategy by providing information about the current and targeted state, goals and objectives, assumptions, dependencies, risks and opportunities, the architecture (including alternatives that need to be explored), direct and interfacing processes, roles involved and their responsibilities, communication paths (including escalation), etc.

Even if the template discusses general aspects, the treatment of best practices is minimal (see some technical and architectural aspects).

The DMS should describe when possible the high-level architecture planned for DM. The architecture section can be updated as the project progresses.

One can plan for 3-4 dry-runs plus the UAT, though further iterations might be needed depending on the data quality, respectively the complexity of the logic needed. Each dry-run will have its own scope (in terms of entities and number of records) and objectives (in terms of passed tests), while the UAT attempts to mimic the same conditions the as DM for Go-Live.

Several iterations are usually needed to identify the entities in scope. Moreover, the scope will suffer several changes as new entities and migration areas are identified. There are high the chances that some data entities will be forgotten or postponed after Go Live. Upon case, the business might approach a phased implementation, each with their own DM,

It's useful to have a list of the entities available in the organization and map them to the entities available in the target system(s). This allows to identify the gaps on the DM side. There will be entities for which data need to be provided, entities for which there's no counterpart in the target system, respectively entities with different levels of detail.

An important step of the process is defining the business rules that apply - what subset of data is migrated (e.g. active referenced master data, open transactions, etc.). The definitions will suffer further changes as business perception about what's needed changes.

As they'll go through multiple changes, it's useful to have such lists in Excel or similar repositories and reference them in the strategy and further documents.

The strategy can also target the post-Go-Live migration activities, though the process and architecture might be slightly different, even if many of the requirements still apply. One can devise the further aspects as part of the DMS or consider them as part of the Data Management strategy and operations.

 Despite the considerable overlapping of the DM with Data Management, at least until now the DM is not considered as part of the latter. Big organizations with periodic DMs might need to consider a broader strategy, following to address punctually the deviations from each project.

The DM is usually considered as a subproject of the implementation and should be managed as such. Depending on its scope and characteristics (principles, acceptance criteria) the DM might use a different methodology and timeline than the main project. Defining project's goals/objectives, outcomes, stakeholders, timeline, phases, and milestones, respectively the high-level assumptions, dependencies, risks, opportunities and constraints is Project Management 101.

The DM is critical for an implementation's success. It would be useful to describe the architectural alternatives, as well to provide a series of architectural recommendations.

Previous Post <<||>> Next Post

Resources:
[1] Microsoft learn (2023) Create a data migration strategy for Dynamics 365 solutions (link)

03 July 2023

Data Migrations (DM): Comments on "Planning for Successful Data Migration" II (Technical Aspects in Dynamics 365 Finance & Operations)



Data Migration
Data Migrations Series

Introduction

This weekend I read the chapter 5 on Data Migrations (Planning for Successful Data Migration) from Brent Dawson’s recently released book "Becoming a Dynamics 365 Finance and Supply Chain Solution Architect" (published by Packt Publishing, available on Amazon). The chapter makes a few good points, however there are statements that require further clarifications, while others can be questionable.

Concerning the Data Migration (DM), besides several architectural recommendations, the author makes also several technical recommendations that can be summarized as follows:

(10) migrate transactional data manually via direct input or by using the Excel add-in (and it doesn’t recommend migrating transactional data using data packages because data change frequently)
(11) put in place a data outage should be as a part of the cutover timeframe
(12) new transactional data should be migrated after Go-live;
(13) include the effort for data entry in the cutover plan.

General Aspects

In what concerns the data there are 4 important phases during a cutover: configuring the production environment, migrating the master data, migrating the transactional data, respectively importing/creating the new transactional data. After each of these phases a data validation step is required to assure and sign-off on data quality.

Ideally, one can make sure that the production environment is correctly set up by deploying a copy of the database with the gold configuration (e.g. export the database and restore it in the target environment). Otherwise, direct data entry and templates, when available, can help obtain the same result, though the effort and risks for errors are higher.

Moving to next phases, it’s important to understand that a data migration is not a copy paste of some data from one system to another. Often the systems have different schemas, data definitions or granularity of the data entities. Ideally, a DM layer in between should take as input the source data and prepare the load data for the target system. This applies to master as well as to transactional data.

For importing data in D365 FO there are the following main options:
(a) manual data entry
(b) import via Excel-add in and templates
(c)  manual/automated data packages
(d) batch API

As rule of thumb, if one has no more than 100-200 records for a data entity, it might be Ok to enter the data manually, eventually by splitting the effort between several users. This would allow users to accommodate themselves with the system, even if errors are made in the process. However, giving the importance of having “clean data” and a repeatable process for Go-Live makes this approach less desirable. On the other side, there will be cases when this will be the only available option.

As soon data's volume goes above this threshold, the effort doesn’t make sense. Preparing the data in Excel and importing them via the Excel add-in is in most cases recommended, as long as the volume of data is manageable. Moreover, data can be partitioned and imported in batches of 1000-2000 records. Ideally, the data should be available in the same structure as required by the templates used.

There will be however a second threshold that makes a batch API solution more attractive.  How big is this threshold? It depends. I was able to import 50-100k records via partitioning in Excel add-in, though these values shouldn’t be taken as fix.

The dependencies existing between data will dictate the order in which data must be imported, while the size of each data entity can be used to decide which approach will be used.

Master Data

In theory, the migration of master data can start as soon as the corresponding configuration is available. However, it is recommended to split the two phases and make sure that the environment is fully configured. This helps take a backup of the configuration, when such a snapshot is not available (see golden configuration in previous post).

Before taking a snapshot of the master data from the source system(s) it’s recommended to disable the access for changing the respective data (aka master data freeze). Otherwise, besides the fact that the changes will not appear in the target system(s), changes can make master data’s validation more complex. Sometimes, that's a risk the business is willing to take.

The master data are typically imported a few days before the transactional data need to be imported to allow the team to validate the master data and if the data don’t have the expected quality, perform at most one more migration. Thus, the migration of master data can start one or two weeks earlier, however the longer the timeframe, the higher the chances that the business will be impacted by this (e.g. new orders with new products are needed urgently).

Transaction Data

Before migrating the transactional data, a few processes must be run (e.g. monthly/yearly closing, inventory counting, receiving goods in transit, etc.). Once this accomplished, the system can be frozen and thus the access to making changes disabled. This can happen in phases, depending on the requirements (e.g. migrating the balance can happen much later, even weeks after Go-Live).

What one can migrate are only open transactions (e.g. open purchase orders, open sales orders, open customer/vendor invoices, active assets) and balances (e.g. inventory, trial balance). Usually migrating historical data is out of the question. A data warehouse or similar data repository is more appropriate for storing historical data. Otherwise, keeping the source system(s) available for some users for regulatory requirements would be a better option, when feasible.

The biggest issue with transactional data is that the referenced values (products, customers, vendors) must be available in the target system(s). Even if names and descriptions are maybe the same, the unique identifiers or the surrogate keys are more likely to change. E.g. a product, vendor or customer will have other product number, vendor number or customer number than in the source system(s). This means that the old values need to be replaced with the new ones and this can become a tedious and error-prone process even for Excel. Unless the number of records is really small and there’s no other solution, I don’t recommend this approach.

The alternative would be to build a data migration layer that can address many of the challenges of data migrations. The effort for building such a layer might be high comparable with a manual transformation of the data, though it increases the chances of success by a considerable factor.

During and Post-Go-Live

After validating and signing off on the DM, and here extracts from source and target systems can help, the Go-Live will depend only on the functional testing’s results (and many things can go wrong in this area).

During the freeze period(s) of the source systems, more likely that new master and transactional data needed to be created. Ideally, these data should be entered after the Go-Live announcement, though it isn’t a must if a backup of the target system was taken before. For this the Excel add-ins can become the tool of choice.

With the Go-Live the DM should be over, though there will always be inquiries from the business. In fact only when the auditor signed off the DM is over. Even when one thinks that everything is over a few more surprises can appear – forgotten data, data enrichment, data for new features, etc.

Wrap Up

These are the most important aspects the reader should be aware of. There is more to say about the DM architecture and process, there are more best practices that need to be considered in areas like planning, conceptualization, quality assurance, principles, etc.

Comming back to the best practices from the book, it's worth to stress out that the frequency with which data changes is not the main driver for what approach to use in the DM. Definitely more important is the volume and complexity of data entities to be migrated, and this applies to master and transactional data altogether. Therefore, the argumentation behind (10) doesn't stand entirely.

Concerning (11), a multi-level data freeze is more appropriate than an outage, even if the author intended maybe to say the same thing.

(12) and (13) make sense, though the new data are part of daily business (business as usual) and not of the DM. Moreover, if the data entry or import fails because of whatever reason, it can't be the DM to blame. Even if the lessons learned during DM can be further used for mass data entry and updates, this doesn't mean that the DM project continues to exist. In theory, the DM layer can be used further on, though the respective layer was build on different premises that become obsolete with the Go-Live. One needs to think only from the perspective of the new system. Data Management or more specifically Master Data Management should be responsible for this type of data changes!

Previous Post <<||>> Next Post

Data Migrations (DM): Comments on "Planning for Successful Data Migration" I (Architecture Aspects in Dynamics 365 Finance & Operations)



Data Migrations
Data Migrations Series

Introduction

This weekend I read the chapter 5 on Data Migration (Planning for Successful Data Migration) from Brent Dawson’s recently released book "Becoming a Dynamics 365 Finance and Supply Chain Solution Architect" (published by Packt Publishing, available on Amazon). The section on best practices makes many good points, however some of the practices require further clarifications, while some statements can be questionable as the context associated with them can make an important difference.  Overall however the recommendations hold.

Concerining Data Migrations (DM), besides a few teachnical recommendations, the author makes also several architectural recommendations that can be summarized as follows:

(1) put the data into a backup system or database, if possible, and use that system to the data extraction parts of the DM tasks;
(2) use a Tier 2 system for the majority of the development of the data packages;
(3) once the data packages validated, they can be used against production environments;
(4) don’t use the OData protocol for data transfer, but use the Batch API instead;
(5) don’t use dual-write for DM (technology used for data integrations), first complete the DM and after that enable the dual-write;
(6)  have a backup of the environments involved;
(7) have a good internet connection;
(8) plan an environment for DM (at a 2-tier environment, distinct from the one used for functional testing);
(9) for the gold configurations have an environment with limited access.

General Aspects

In a Data Migration there are at least 2 systems involved, though in more complex scenarios there can be one more source systems, respectively one or more target systems. At minimum there is a source and a target system.

Ideally, a target production environment should not be used for testing the data migration! On the other side, as long there’s a backup with a given state of the system (e.g. only configuration data, without master or transactional data) a system can be always restored to a previous state. This applies to D365 or to any system for which a database backup and restore can be applied. Even so, as best practice it isn’t recommended to use a production environment for testing as this can increase the complexity of the data migration.

Moreover, the same constraint applies also to the sandbox used for UAT (User Acceptance Testing), given that is supposed to represent at different points in time the same state as the production environment). Thus, at least a third environment will be needed.

There are no hard constraints on the source systems. Ideally, one should use the production source system(s) or environments that resemble the production environments. A read replica of the respective environment(s) will work as well, given that there are typically only reads involved.

The downside of accessing directly a production environment for DM is that the data changes frequently, which makes it more difficult to validate the DM logic – the time factor needing to be considered – data being added, deleted or changed. That’s why an environment with a recent snapshot from production would facilitate the process and would make sure that the DM workloads don’t affect production environment’s performance.

Often, a better alternative would be to have a database in between (aka DM layer) that contains only the data in scope of DM. ETL (Extract Transfer Load) jobs can extract the data on demand and in a consistent manner, this approach assuring a snapshot. This layer can be used to build, test and troubleshoot the DM logic, before Go-Live and after, as issues will be more likely raised by the business and will need to be mitigated.

There are also scenarios in which the direct access to source systems is not possible, a push, respectively a push & pull scenario being needed. If possible, it would be great if the data needed for migration could be exported directly from the source system(s) as needed by the target system(s). In some scenarios this might be achievable, though the bigger the differences in schemas betweeen the systems and the more complex the data, the more transformations are needed, respectively the more difficult it becomes to achieve this. Therefore, moving such logic to an intermediate DM layer would facilitate the DM architecture allowing to address many of the challenges.

Batch API

Using Batch API could be a solution when the source environments allow only API access to the data (thus no direct access over SQL scripting) or when the volume of data makes the alternatives unusable. Indeed, OData seems to be slow or unusable when the volume of data exceeds a given threshold, even if the calls can be partitioned.

Another scenario for Batch API is when the source and target systems need to operate in parallel for a considerable amount of time that would make other approaches unusable. Even if a DM typically involves the replacement of one or more systems, there can be exceptions. Such scenario increases a DM’s complexity by several factors and should be avoided. Even if such scenarios seem to be logical and approachable at first sight, the benefits can be easily outrun by the downsides.

Backup

Hopefully, your organization has a backup and restore strategy for the production and other essential environments! The strategy needs to be extended also for the further environments available during the implementation. It’s also true that until Go-Live the target environments don’t suffer many changes. Ideally, a backup should be taken at least when important changes are made to the systems. This can involve the configuration as well the DM. E.g. a setup would be required after the configuration is completed, when the master data, respectively when the transactional data was migrated. A backup of all the systems involved should be taken before Go-Live.

Gold Configuration

Having a system with the gold configuration (the values used to configure the system) available can indeed facilitate the implementation and there are two main reasons for this. Primarily, the gold configuration allows to build reliable processes around its maintenance and to minimize the risk of having discrepancies between expectations and reality. Secondly, the database with the gold configuration can be used to easily setup a new environment and this might be needed often than thought (e.g. for dry runs).

However, in praxis the technical value is easily overrun by the financial aspect as such an environment is barely used and can involve significant costs. As alternative one can use the DAT legal entity from an available environment for storing the gold configuration common across all the legal entities and easily copy it to the other legal entities. In addition, it’s needed to document the deviations, however it’s recommended to document all configurations and use this as baseline for the post-Go-Live changes.
Indeed, the access to the gold configuration should be restrained as much as possible (e.g. only admin, consultants and/or data owners) and change policies should be enforced. Otherwise, one risks having different configurations between the environments. For Go-Live it is critical that the UAT and Go-Live environments have the same configuration.

Independently of the approach used to maintain the gold configuration, it’s recommended to perform a comparison between UAT and production environments to make sure that there are no differences. The comparison can be handled also via SQL scripts, the effort being well-spent when such comparisons needed to be done several times. Even if the data from production isn’t directly accessible, a snapshot of the production database can be copied in another environment. However, this approach requires a good understanding of the tables and/or entities involved. There will be cases (e.g. module parameters) in which it’s easier to perform a manual comparison.

Wrap Up

Coming back to the recommendations, the only points that require some discussion are (1), (2) and maybe (8), while (9) was discussed above (see 'Gold configuration' section).

The recommendation of putting the data into a backup system or database is too vague. A backup system can mean a backup database that can be accessible typically only over DRBMS or an instance of the system having a copy of the data (which usually implies a RDBMS as well). Besides these, a database can refer to a read replica of source system's database or to a DM layer.

Besides price and performance, the main differences between a Tier-1 and a Tier-2 environment (see also the Microsoft documentation) rely in the number of VM machines (aka boxes) involved, how the various components are distributed between them, respectively the edition of SQL Server used. Otherwise, for the users the system will look the same. The most important constraint is that a Tier-1 isn't suitable for UAT or performance testing. In other words, the environment will be slow for concurrent use.

If the performance is acceptable, if the volume of data and the number of users is small, a Tier-1 environment can be used for building data packages, performing initial DM dry-runs and other tasks. However, a Tier-2 resembles closer the production environment and if the UAT is performed using such a system, the more likely is to identify and address the bottlenecks related to performance. Unless they accept the costs blindly, the customers will need to trade between performance and costs from the perspective of their requirements and their business context.

04 February 2021

Data Migrations (DM): Conceptualization VII (Data Import Layer)

Data Migration
Data Migrations Series

The data requirements for the Data Migration (DM) and Data Quality (DQ) are driven by the processes implemented in the target system(s). Therefore, a good knowledge of these requirements can decrease the effort needed for these two subprojects considerably. The needed knowledge basis starts with the entities and their attributes, the dependencies existing between them and the various rules that apply, and ends with the parametrization requirements, respectively the architecture(s) that can be used to import the data.

The DM process starts with defining the entities in scope and their attributes, respectively identifying the corresponding entities and attributes from the legacy systems. The attributes not having a correspondent in the legacy system need to be provided by the business and integrated in the DM logic. In addition, it’s needed to consider also the attributes needed by the business and not available in the target system, some of them more likely available in the legacy systems. For such attributes is needed either to misuse an attribute from the target or to extend the target system.

For each entity is created a data mapping that basically documents the data transformations needed for migrating the data. In the process is needed to consider also attributes’ data types, the (standard) formatting, their domain of definition, as well the various rules that apply. Their implementation belongs into the DM layer from which the data are exported in a standard format as needed by the target system.

Exporting the data from the DM layer directly into the target system’s tables has in theory the lowest overhead even if the rejected records are difficult to track, the rejections resulting only from records’ ‘validation against database’s schema. For this approach to work, one must have a good knowledge of the database schema and of the business rules implemented into the target system.

To solve the issue with errors’ logging, systems have a further layer on top of the database model, which also allow running data validation against target system’s business rules. Modern import frameworks allow loading the data via a set of standard files with a predefined structure. The data can be thus imported manually or via load jobs into the system a log with the issues being generated in the process. Some frameworks allow even the manual editing of failed records, respectively to import the data. Unfortunately, calling the layer from the DM layer is not possible from a database, though this would bring seldom a benefit. Some third-party tools attempt to improve the import functionality by calling the target system’s import layer.

The import files must be generated from the DM layer in the required structure with the appropriate formatting. The challenge however resides in identifying all the attributes that should make scope of the load. It’s an iterative process which sometimes is backed by try-and-error heuristics. Unless target system’s validation rules are known beforehand, the rules need to be discovered in this process, which can prove time-consuming. The discoveries need to be integrated also in the DM and from here results the big number of changes that need to be performed.

Given the dependencies existing between entities the files need to be generated and loaded in a predefined order. These dependencies are reflected also in the data processing and the validation rules considered in the DM layer.

A quality checkpoint can be implemented between the export from the DM layer and import to enforce the four-eyes principle. It’s normally the last opportunity for trapping the eventual issues. A further quality check is performed after import by validating on whether the data were imported as expected.

Previous Post <<||>> Next Post

Data Migrations (DM): Conceptualization VI (Data Migration Layer)

Data Migration
Data Migrations Series

Besides migrating the master and transactional data from the legacy systems there are usually three additional important business requirements for a Data Migration (DM) – migrate the data within expected timeline, with minimal disruption for the business, respectively within expected quality levels. Hence, DM’ timeline must match and synchronize with main project’s timeline in terms of main milestones, though the DM needs to be executed typically within a small timeframe of a few days during the Go-Live. In what concerns the third requirement, even if the data have high quality as available in the source systems or provided by the business, there are aspects like integration and consistency that rely primarily on the DM logic.

To address these requirements the DM logic must reach a certain level of performance and quality that allows importing the data as expected. From project’s beginning until UAT the DM team will integrate the various information iteratively, will need to test the changes several times, troubleshoot the deviations from expectations. The volume of effort required for these activities can be overwhelming. It’s not only important for the whole solution to be performant but each step must be designed so that besides fast execution, the changes and troubleshooting must involve a minimum of overhead.

For better understanding the importance, imagine a quest game in which the character has to go through a labyrinth with traps. If the player made a mistake he’ll need to restart from a certain distant point in time or even from the beginning. Now imagine that for each mistake he has the possibility of going one step back try a new option and move forward. For some it may look like cheating though in this way one can finish the game relatively quickly. It would be great if executing a DM could allow the same flexibility.

Unfortunately, unless the data are stored between steps or each step is a different package, an ETL solution doesn’t provide the flexibility of changing the code, moving one step behind, rerunning the step and performing troubleshooting, and this over and over again like in the quest game. To better illustrate the impact of such approach let’s consider that the DM has about 40 entities and one needs to perform on average 20 changes per entity. If one is able to move forwards and backwards probably each change will take about a few minutes to execute the code. Otherwise rerunning a whole package can take 5-10 times or even more as this can depend on packages’ size and data volume. For 800 changes only an additional minute per change equates with 800 minutes (about 13 hours).

In exchange, storing the data for an entity in a database for the important points of the processing and implementing the logic as a succession of SQL scripts allows this flexibility. The most important downside is that the steps need to be executed manually though this is a small price to pay for the flexibility and control gained. Moreover, with a few tricks one can load deltas as in the case of a phased DM.

To assure that the consistency of the data is kept one needs to build for each entity a set of validation queries that check for duplicates, for special cases, for data integrity, incorrect format, etc. The queries can be included in the sequence of logic used for the DM. Thus, one can react promptly to each unexpected value. When required, the validation rules can be built within reports and used in the data cleaning process by users, or even logged periodically per entity for tracking the progress.

Previous Post <<||>> Next Post

03 February 2021

Data Migrations (DM): Conceptualization V (Data Extraction Layer)

Data Migration

ETL tools are ideal for extracting the needed data from the legacy system(s). They offer a considerable number of connectors to standard databases that leverage legacy systems’ data access layers or own frameworks, both categories providing acceptable performance for a wide range of solutions. Otherwise, third-party connectors can be considered as well, though their advantage might reside in the extra features they bring out-of-the-box in the detriment of performance loss, and thus should be used with caution.

Besides that, ETL tools provide also rich visual functionality that allow users building complex pipelines with transformations that process the data as data go through the pipeline. Further features like data profiling or cleansing bring additional benefits.

As usually only a subset of the legacy data is needed for the migration, an ETL solution allows extracting only the data in scope as filtering and other logic can be used in the extraction mechanism. Whether one loads the tables or entities 1:1 or aggregates the data from multiple tables is a matter of choice, even if the former two approaches are usually recommended.

As alternative to an ETL tool is building own extraction layer based for example on a powerful data access layer like ADO.Net. This might prove to be a cheaper alternative especially when ETL capabilities aren’t needed. This depends also on the overall architectural approach. Attempting to build a desktop-based application for a DM can prove to be a foolhardy approach especially when dealing with a considerable volume of data. Moreover, it would be needed to build features that are already available in ETL tools (transformations, workflows) or databases (indexes for performance optimization, join-based logic).

When the volume of data exceeds the capabilities of ETL tools one can consider ELT tools which load first the data before applying any transformations on them. Such tools are designed for the processing of what is known as big data (data having high volume, high velocity, high variety and different veracity).

When considering the best data extraction approach, it’s important to know where the data will be stored for processing. Given that DMs are data processing intensive the best data storage solution for processing would be a modern relational database. Besides performance, scalability, security, concurrency, failover mechanism some databases offer the possibility to connect directly to other servers via server links functionality. Despite this latter feature an ETL tool can still have considerable advantages for data extraction.

On the other side the DM logic can be in theory built entirely in the ETL tool without storing the data within a database, though this adds a high overhead on the server resources on which the solution runs as all the data needed for processing need to be loaded in memory. Even if the data are loaded in batches and processed as the batches go through the pipeline, the complexity of the processing can make challenging implementing any optimization techniques directly into the ETL tool. Moreover, fully ETL-based solutions are difficult to troubleshoot and change as the requirements change.

To address the high resources’ consumption of the ETL tools one can store the intermediary results into database tables on which indexes can be created for performance optimization. Moreover, the logic can be encapsulated in database objects and used in the processing. This approach enables troubleshooting, performing validations and restarting the processing from a given step in the detriment of splitting the logic between multiple ETL packages. This can be an acceptable price to pay for more flexibility. Given that most ETL transformations can be replaced with SQL-based logic the ETL tool can be used only for data extraction.

Previous Post <<||>> Next Post

Data Migrations (DM): Conceptualization III (Heuristics)

Data Migration

Probably one of the most difficult things to learn as a technical person is using the right technology for a given purpose, this mainly because one’s inclined using the tools one knows best. Moreover, technologies’ overlapping makes the task more and more challenging, the difference between competing technologies often residing in the details. Thus, identifying the gaps resumes in understanding the details of the problem(s) or need(s), respectively the advantages or disadvantages of a technology over the other. This is true especially about competing technologies, including the ones that replace other technologies.

There are simple heuristics, that can allow approaching such challenges. For example, heavy data processing belongs usually in databases, while import/export functionality belongs in an ETL tool.  Therefore, one can start looking at the problems from these two perspectives. Would the solution benefit from these two approaches or are there more appropriate technologies (e.g. data streaming, ELT, non-relational databases)? How much effort would involve building the solution?

Commercial Off-The-Shelf (COTS) tools provided by third-party vendors usually offer specialized functionality in each area. Gartner and Forrester provide regular analyses of the main players in the important areas, analyses which can be used in theory as basis for further research. Even if COTS tend to be more expensive and can have some important functionality gaps, as long they are extensible, they can prove a good starting point for developing a solution.

Sometimes it helps researching on the web what other people or organizations did, how they approached the same aspects, what technologies, techniques and best practices they used to overcome the challenges. One doesn’t need to reinvent the wheel even if it’s sometimes fun to do so. Moreover, a few hours of research can give one a basis of useful information and a better understanding over the work ahead.

On the other side sometimes it’s advisable to use the tools one knows best, however this can lead also to unusable and less performant solutions. For example, MS Excel and Access have been for years the tools of choice for building personal solutions that later grew into maintenance nightmares for the IT team. Ideally, they can still be used for data entry or data cleaning, though building solutions exclusively based on (one of) them can prove to be far than optimal.

When one doesn’t know whether a technology or mix of technologies can be used to provide a solution, it’s recommended to start a proof-of-concept (PoC) that would allow addressing most important aspects of the needed solution. One can start small by focusing on the minimal functionality needed to check the main aspects and evolve the PoC during several iterations as needed.

For example, in the case of a Data Migration (DM) this would involve building the data extraction layer for an entity, implement several data transformations based on the defined mappings, consider building a few integrity rules for validation, respectively attempt importing the data into the target system. Once this accomplished, one can start increasing the volume of data to check how the solution behaves under stress. The volume of data can be increased incrementally or by considering all the data available.

As soon the skeleton was built one can consider all the mappings, respectively add several entities to build the dependencies existing between them and other functionality. The prototype might not address all the requirements from the beginning, therefore consider the problems as they arise. For example, if the volume of data seems to cause problems then attempt splitting the data during processing in batches or considering specific optimization techniques like indexing or scaling techniques like increasing computing resources.

Previous Post <<||>> Next Post

Data Migrations (DM): Conceptualization II (Plan vs. Concept vs. Strategy)

Data Migration
Data Migrations Series

A concept is a document that describes at high level the set of necessary steps and their implications to achieve a desired result, typically making the object of a project. A concept is usually needed to provide more technical and nontechnical information about the desired solution, the context in which a set of steps are conducted, respectively the changes considered, how the changes will be implemented and the further aspects that need to be considered. It can include a high-level plan and sometimes also information that typically belong in a Business Case – goals,objectives, required resources, estimated effort and costs, risks and opportunities.

A concept is used primarily as basis for sign-off as well for establishing common ground and understanding. When approved, it’s used for the actual implementation and solution’s validation. The concept should be updated as the project progresses, respectively as new information are discovered.

Creating a concept for a DM can be considered as best practice because it allows documenting the context, the technical and organizational requirements and dependencies existing between the DM and other projects, how they will be addressed. The concept can include also a high-level plan of the main activities (following to be detailed in a separate document).

Especially when the concept has an exploratory nature (due to incomplete knowledge or other considerations), it can be validated with the help of a proof-of-concept (PoC), the realization of a high-level-design prototype that focuses on the main characteristics of the solution and allows thus identifying the challenges. Once the PoC implemented, the feedback can be used to round out the concept.

Building a PoC for a DM should be considered as objective even when the project doesn’t seem to meet any major challenges. The PoC should resume in addressing the most important DM requirements, ideally by implementing the whole or most important aspects of functionality (e.g. data extraction, data transformations, integrity validation, respectively the import into the target system) for one or two data entities. Once the PoC built, the team can use it as basis for the evolutive development of the solution during the iterations considered.

A strategy is a set of coordinated and sustainable actions following a set of well-defined goals, actions devised into a plan and designed to create value and overcome further challenges. A strategy has the character of a concept though it has a broader scope being usually considered when multiple projects or initiatives compete for the same resources to provide a broader context and handle the challenges, risks and opportunities. Moreover, the strategy takes an inventory of the current issues and architecture – the 'AS-IS' perspective and sketches the to 'TO-BE' perspective by devising a roadmap that bridges the gap between the two.

In the case of a DM a strategy might be required when multiple DM projects need to be performed in parallel or sequentially, as it can help the organization to better manage the migrations.

A plan is a high-level document that describes the tasks, schedule and resources required to carry on an activity. Even if it typically refers to the work or product breakdown structure, it can cover other information usually available in a Business Case. A project plan is used to guide both project execution and project control, while in the context of Strategic Management the (strategic) plan provides a high-level roadmap on how the defined goals and objectives will be achieved during the period covered by the strategy.

For small DM projects a plan can be in theory enough. As both a strategy and a concept can include a high-level plan, the names are in praxis interchangeable.

Previous Post <<||>> Next Post

02 February 2021

Data Migrations (DM): Conceptualization I (Goals, Objectives & Requirements)

Data Migration
Data Migrations Series

One of the nowadays’ challenges is finding the right mix of technologies that allows building a solution for a business need. There are so many choices and the responsible person is easily tempted to use one of the trending technologies just because he wants to learn something new or the technologies seem to fit into the bigger picture, which probably in many cases it would be acceptable. Unfortunately, there’s also the tendency of picking a technology without looking at what functionality it provides, respectively whether the functionality meets intended solutions’ requirements. Moreover, the requirements are sometimes barely defined at the appropriate level of detail, fact that makes from the implementation project a candidate for failure. Sometimes even the goals and objectives aren’t clearly stated, fact that can make a project’s success easily questionable from the beginning.

A goal is a general statement that reflects the desired result toward which an organization’s effort needs to be directed. For example, a Data Migration (DM)’s primary goal can be formulated as 'to make available all the master and transactional data needed by the business from the legacy systems to the target system(s) within expected timeline and quality with a minimal disruption for the business'.

An objective is a break down of the goal into several components that should foster a clear understanding on how the goal will be achieved. Ideally the objectives should be SMART (specific, measurable, attainable, relevant, time-bound), even if measurable objectives are sometimes hard to define properly. One can consider them as the tactics used in achieving the goal. For example, the above formulated goal can be broken down into the following objectives:

  • Build a DM concept/strategy
  • Build a flexible and performant infrastructure for DM that can be adapted to further requirements
  • Provide a basis for further DMs
  • Align DM and main project’s requirements and activities
  • Provide an interface and support for the Data Management areas
  • Foster trust, transparency and awareness
  • Address internal/external compliance requirements
  • Document and communicate accountability for the various activities
  • Cleanse and enrich the data needed by the target system
  • Archive the DM and project data

One can attempt defining the objectives directly from the goal(s), though unless one is aware of all the implication a DM has, more likely one will be forced to define and evaluate the individual functional and nonfunctional requirements for the DM first, and attempt consolidating the requirements into a set of objectives. In the end it can be a combination of both, in which some objectives are first formulated, the requirements are defined and evaluated, respectively the objectives are refined to accommodate the requirements.

ISO 9126, an international standard for the evaluation of software quality, defines about 45-50 attributes that can be used for addressing the requirements of software solutions, attributes that reflect functionality, reliability, usability, efficiency, and maintainability characteristics. One can start with such a list and identify how important are the respective attributes for the solution.  The next step would be to document the requirements into a consolidated list by providing a short argumentation for their use, respectively how they will be addressed as part of the solution. The process can prove to be time-consuming, however it is a useful exercise that usually needs to be done only once and be reviewed occasionally.

The list can be created independently of any other documentation or be included directly into a concept or strategy. The latter will assure in theory that the document provides a unitary view of the migration, considering that each new or obsolete requirement can impact the concept.

Previous Post <<||>> Next Post

01 February 2021

Data Migrations (DM): Quality Acceptance Criteria V

Data Migration

Efficiency

Efficiency is the degree to which a solution uses the hardware (storage, network) and other organizational resources to fulfill a given task. Data characterized by high volume, velocity, variety and veracity can be challenging to process, requiring upon case more processing power. Therefore, the DM solutions need to consider these aspects as well. However, efficiency refers on whether the available resources are used efficiently – the waste in terms of resource utilization is minimal.

On the other side the waste of resources can be acceptable when there are other benefits or requirements that need to be considered, respectively when the ratio between resources utilization and effort to built more efficient processes is acceptable.

A DM solution involves iterative and exploratory processes in which knowledge and feedback is integrated in each iteration, therefore it might look like resources are not used efficiently. However, this is a way to handle complexity and uncertainty by breaking the effort in manageable chunks.

Learnability

Learnability is the degree to which a person can become familiar with a solution’s use, the data and the processes associated with it. A DM can be challenging for many technical and non-technical resources as it requires a certain level of skillset and understanding of the requirements, needs and deliverables. The complexity of the data and requirements can be overwhelming, however with appropriate communication and awareness established, the challenges can be overcome.

Stability

Stability is the degree to which a solution is sensitive to environment changes (e.g. overuse of resource, hardware or software failures, updates), respectively on whether it performs with no performance defects or it does not crash under defined levels of stress. Stability can be monitored during the various phases and countermeasures need to be considered in case the solution is not stable enough (e.g. redesigning the solution, breaking the data in smaller chunks)

Suitability

Suitability is the degree to which a solutions provides functions that meet the stated and implied needs. No matter how performant and technologically advanced a solution is, it brings less value as long it doesn’t perform what it was intended to do.

Transparency

Transparency is the degree to which a solution’s stakeholders have access to the requirements, processes, data, documentation, or other information required by them. In a DM transparency is important especially important in respect to the data, logic and rules used in data processing, respectively the number of records processed.

Trustability

Trustability is the degree to which a solution can be trusted to provide the expected results. Even if the technical team assures that the solution can deliver what was indented, the success of a DM is a matter of perception from stakeholders’ perspective. Providing transparency into the data, rules and processes can improve the level of trust however, special attention need to be given to the issues raised by stakeholders during and after Go-Live, as differences need to be mitigated.

Understandability

Understandability is the degree to which the requirements of a solution were understood by the resources involved in terms of what needs to be performed. For the average project resource it might be challenging to understand the implications of a DM, and this can apply to technical as well non-technical resources. Making people aware of the implications is probably one of the most important criteria for success, as the success of a migration is often a matter of perception.

Usability

Usability is the degree to which a solution can be used by the targeted users within the agreed context of usage. Ideally DM solutions need to be easy to use, though there are always trade-offs. In the end, a DM must fit the purpose it was built for.

Previous Post <

Data Migrations (DM): Quality Acceptance Criteria IV

Data Migration
Data Migrations Series

Reliability

Reliability is the degree to which a solution performs its intended functions under stated conditions without failure. In other words, a DM is reliable if it performs what was intended by design. The data should be migrated only when migration’s reliability was confirmed by the users as part of the sign-off process. The dry-runs as well the final iteration for the UAT have the objective of confirming solution’s reliability.

Reversibility

Reversibility is the degree to which a solution can return to a previous state without starting the process from the beginning. For example, it should be possible to reverse the changes made to a table by returning to the previous state. This can involve having a copy of the data stored respectively deleting and reloading the data when necessary.

Considering that the sequence in which the various activities is fix, in theory it’s possible to address reversibility by design, e.g. by allowing to repeat individual steps or by creating rollback points. Rollback points are especially important when loading the data into the target system.

Robustness

Robustness is the degree to which the solution can accommodate invalid input or environmental conditions that might affect data’s processing or other requirements (e,g. performance). If the logic can be stabilized over the various iterations, the variance in data quality can have an important impact on a solutions robustness. One can accommodate erroneous input by relaxing schema’s rules and adding further quality checks.

Security

Security is the degree to which the DM solution protects the data so that only authorized people have access to the respective data to the defined level of authorization as data are moved through the solution. The security provided by a solution needs to be considered against the standards and further requirements defined within the organization. In case no such standards are available, one can in theory consider the industry best practices.

Scalability

Scalability is the degree to which the solution is able to respond to an increased workload.  Given that the number of data considered during the various iterations vary in volume, a solution’s scalability needs to be considered in respect to the volume of data to be migrated.

Standardization

Standardization is the degree to which technical standards were implemented for a solution to guarantee certain level of performance or other aspects considered as import. There can be standards for data storage, processing, access, transportation, or other aspects associated with the migration processes. Moreover, especially when multiple DMs are in scope, organizations can define a set of standards and guidelines that should be further considered.

Testability

Testability is the degree to which a solution can be tested in the respect to the set of functional and data-related requirements. Even if for the success of a migration are important the data in their final form, to achieve that is needed to validate the logic and test thoroughly the transformations performed on the data. As the data go trough the data pipelines, they need to be tested in the critical points – points where the data suffer important transformations. Moreover, one can consider record counters for the records processed in each such critical point, to assure that no record was lost in the process.

Traceability

Traceability is the degree to which the changes performed on the data can be traced from the target to the source systems as record, respectively at entity level. In theory, it’s enough to document the changes at attribute level, though upon case it might needed to document also the changes performed on individual values.

Mappings at attribute level allow tracing the data flow, while mappings at value level allow tracing the changes occurrent within values.

Data Migrations (DM): Quality Acceptance Criteria III

Data Migration
Data Migrations Series

Repeatability

Repeatability is the degree with which a DM can be repeated and obtain consistent results between repetitions. Even if a DM is supposed to be a one-time activity for a project, to guarantee a certain level of quality it’s important to consider several iterations in which the data requirements are refined and made sure that the data can be imported as needed into the target system(s). Considered as a process, as long the data and the rules haven’t changed, the results should be the same or have the expected level of deviation from expectations.

This requirement is important especially for the data migrated during UAT and Go-Live, time during which the input data and rules need to remain frozen (even if small changes in the data can still occur). In fact, that’s the role of UAT – to assure that the data have the expected quality and when compared to the previous dry-run, that it attains the expected level of consistency.

Reusability

Reusability is the degree to which the whole solution, parts of the logic or data can be reused for multiple purposes. Master data and the logic associated with them have high reusability potential as they tend to be referenced by multiple entities.

Modularity

Modularity is the degree to which a solution is composed of discrete components such that a change to one component has minimal impact on other components. It applies to the solution itself but also to the degree to which the logic for the various entities is partitioned so to assure a minimal impact.

Partitionability

Partitionability is the degree to which data or logic can be partitioned to address the various requirements. Despite the assurance that the data will be migrated only once, in practice this assumption can be easily invalidated. It’s enough to increase the system freeze by a few days and/or to have transaction data that suddenly requires master data not considered. Even if the deltas can be migrated in system manually, it’s probably recommended to migrate them using the same logic. Moreover, the performing of incremental loads can be a project requirement.

Data might need to be partitioned into batches to improve processing’s performance. Partitioning the logic based on certain parameters (e.g. business unit, categorical values) allows more flexibility in handling other requirements (e.g. reversibility, performance, testability, reusability).

Performance

Performance refers to the degree a piece of software can process data into an amount of time considered as acceptable for the business. It can vary with the architecture and methods used, respectively data volume, veracity, variance, variability, or quality.

Performance is a critical requirement for a DM, especially when considering the amount of time spent on executing the logic during development, tests and troubleshooting, as well for other activities. Performance is important during dry-runs but more important during Go-Live, as it equates with a period during which the system(s) are not available for the users. Upon case, a few hours of delays can have an important impact on the business. In extremis, the delays can sum up to days.

Predictability

Predictability is the degree to which the results and behavior of a solution, respectively the processes involve are predictable based on the design, implementation or other factors considered (e.g. best practices, methodology used, experience, procedures and processes). Highly predictable solutions are desirable, though reaching the required level of performance and quality can be challenging.

The results from the dry-runs can offer an indication on whether the data migrated during UAT and Go-Live provide a certain level of assurance that the DM will be a success. Otherwise, an additional dry-run should be planned during UAT, if the schedule allows it.

Previous Post <> Nest Post

Data Migrations (DM): Quality Acceptance Criteria II

Data Migration
Data Migrations Series

Auditability

Auditability is the degree to which the solution allows checking the data for their accuracy, or for their quality in general, respectively the degree to which the DM solution and processes allow to be audited regarding compliance, security and other types of requirements. All these aspects are important in case an external sign-off from an auditor is mandatory.

Automation

Automation is the degree to which the activities within a DM can be automated. Ideally all the processes or activities should be automated, though other requirements might be impacted negatively. Ideally, one needs to find the right balance between the various requirements.

Cohesion

Cohesion is the degree to which the tasks performed by the solution, respectively during the migration, are related to each other. Given the dependencies existing between data, their processing and further project-related activities, DM imply a high degree of cohesion that need to be addressed by design.

Complexity

Complexity is the degree to which a solution is difficult to understand given the various processing layers and dependencies existing within the data. The complexity of DM revolve mainly around the data structures and the transformations needed to translate the data between the various data models.

Compliance

Compliance is the degree to which a solution is compliant with internal or external regulations that apply. There should be differentiated between mandatory requirements, respectively recommendations and other requirements.

Consistency

Consistency is the degree to which data conform to an equivalent set of data, in this case the entities considered for the DM need to be consistent to each other. A record referenced in any entity of the migration need to be considered, respectively made available in the target system(s) either by parametrization or migration.

During each iteration, the data need to remain consistent, so it can facilitate the troubleshooting. The data are usually reimported between iterations or during same iteration, typically to reflect the changes occurred in the source systems or other purposes.

Coupling

Data coupling is the degree to which different processing areas within a DM share the same data, typically a reflection of the dependencies existing between the data. Ideally, the areas should be decoupled as much as possible.

Extensibility

Extensibility is the degree to which the solution or parts of the logic can be extended to accommodate further requirements. Typically, this involves changes that deviate from the standard functionality. Extensibility impacts positively the flexibility.

Flexibility

Flexibility is the degree to which a solution can handle new requirements or ad-hoc changes to the logic. No matter how good everything was planned there’s always something forgotten or new information is identified. Having the flexibility to change code or data on the fly can make an important difference.

Integrity

Integrity is the degree to which a solution prevents the changes to data besides the ones considered by design. Users and processes should not be able modifying the data besides the agreed procedures. This means that the data need to be processed in the sequence agreed. All aspects related to data integrity need to be documented accordingly.

Interoperability

Interoperability is the degree to which a solution’s components can exchange data and use the respective data. The various layers of a DM’s solutions must be able to process the data and this should be possible by design.

Maintainability

Maintainability is the degree to which a solution can be modified to or add minor features, change existing code, corrects issues, refactor code, improve performance or address changes in environment. The data required and the transformation rules are seldom known in advance. The data requirements are definitized during the various iterations, the changes needing to be implemented as the iterations progress. Thus, maintainability is a critical requirement.

Previous Post - Next Post

Related Posts Plugin for WordPress, Blogger...

About Me

My photo
IT Professional with more than 24 years experience in IT in the area of full life-cycle of Web/Desktop/Database Applications Development, Software Engineering, Consultancy, Data Management, Data Quality, Data Migrations, Reporting, ERP implementations & support, Team/Project/IT Management, etc.
